Titan I 850-C
Squadron: 850th SMS
Date Activated: December 1st 1960
Date Deactivated: March 25th 1965
Air Force Base: Ellsworth
State: South Dakota

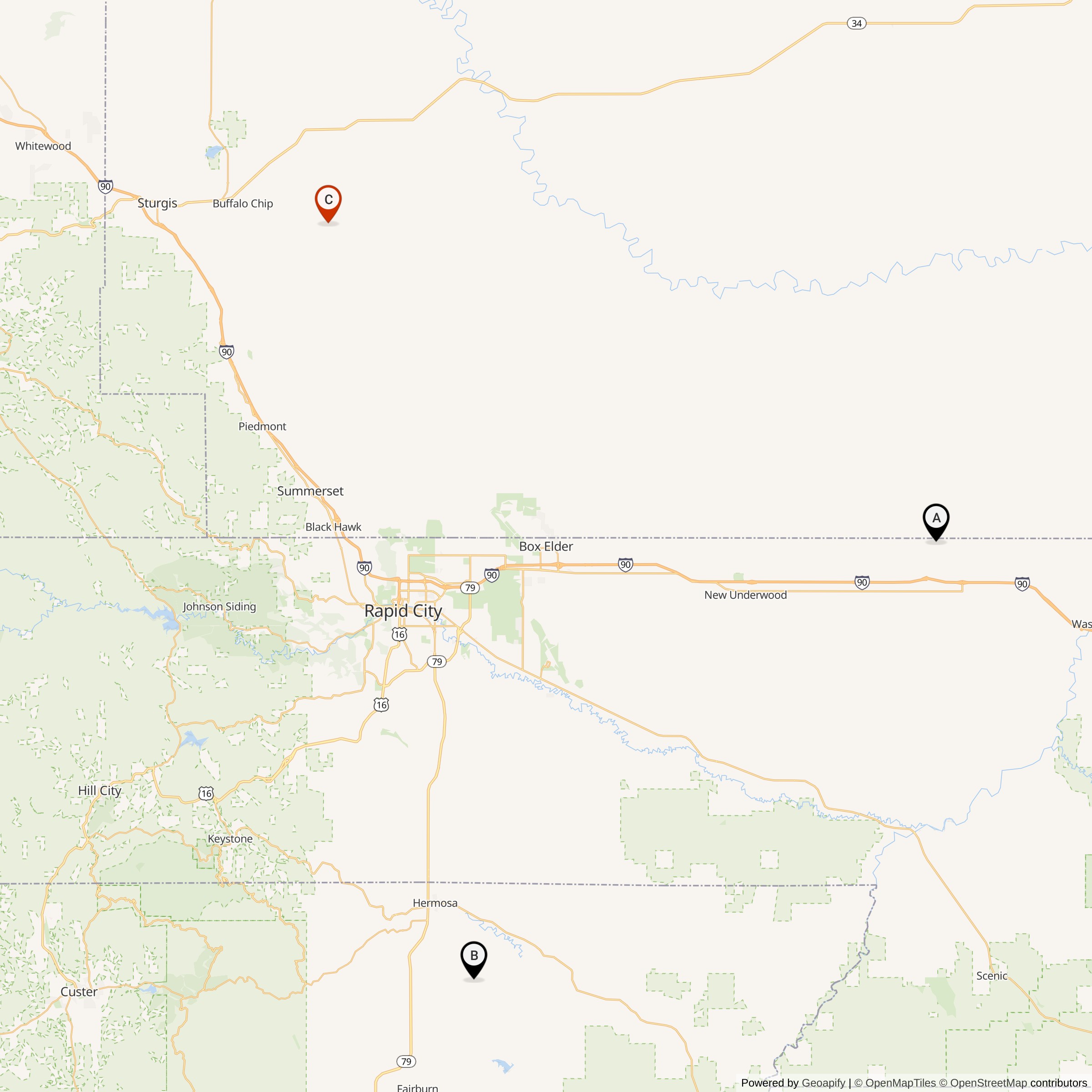

Nearest Town: Sturgis
Coordinates:
Latitude: 44°23'52.64"N
Longitude: 103°18'47.82"W
Decimal:
3 silos
Former Titan I Missile Complex with the 850th Strategic Missile Squadron
Read about the Titan I at Ellsworth AFB
List of all Titan I site Coordinates
Detailed information about the Titan I Intercontinental Ballistic Missile can be found here.

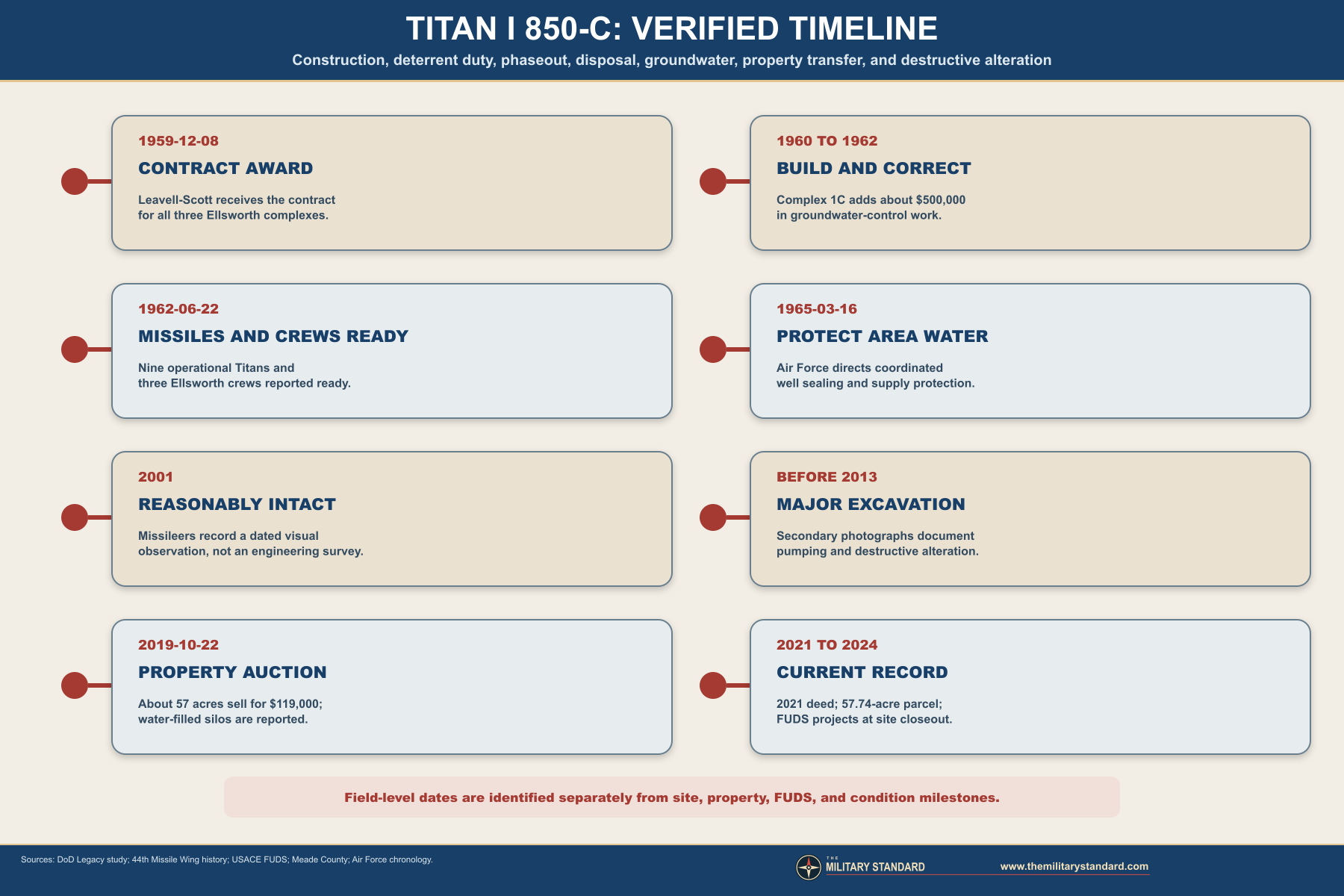

The Sturgis complex was also the field's most difficult documented construction location. The official Department of Defense synthesis records a groundwater-control problem at Complex 1C that cost approximately $500,000. The problem illustrates why standardized plans did not produce identical construction histories. Local geology and groundwater could change excavation, pumping, waterproofing, drainage, schedule, and cost even when the finished military function was the same.
The 850th Strategic Missile Squadron entered the national deterrent during rapid technological change. Ellsworth received nine operational Titan I missiles and had three crews ready on June 22, 1962. Four months later, the Cuban Missile Crisis placed the wing in an advanced state of readiness, and Ellsworth's Titan crews reportedly remained on heightened alert for 72 hours. Titan I was removed from alert on January 4, 1965, and the squadron was inactivated on March 25.
Water remained important at phaseout. On March 16, 1965, Air Force civil engineers were directed to meet with Sturgis officials, the Sturgis Water Works Company, and the South Dakota Water Resources Commission to determine how to seal wells at Complex C while protecting the Sturgis water supply and nearby well owners. The directive does not prove contamination or a connection to the municipal system. It proves that site closure required deliberate groundwater protection.
The postmilitary property passed into private ownership. A 2001 missileers' visit described the Sturgis and Hermosa complexes as reasonably intact. A secondary photographic history documents major excavation and dismantling before February 2013. A 2019 local-news auction report described 57 acres, three water-filled silos, a steel building, farm equipment, and extensive work already performed. Meade County's 2024 parcel layer identifies 57.74 assessed acres and a July 26, 2021 deed to Briggs Hay Company LLC.
Official sources apply several names to the same complex. The Department of Defense legacy study calls the locality Sturgis. The Corps of Engineers uses Ellsworth AFB Air Force Facility S-3 and property number B08SD0345. Operational shorthand includes 850-C, Site C, Site 3, and Complex 1C. These names identify one three-launcher complex rather than separate installations.
The project point and the Corps FUDS point both fall inside the current county parcel. Their small separation reflects different generalized reference systems. Neither coordinate was published as a precise launcher, gate, property corner, road entrance, well, or current safe-access point.

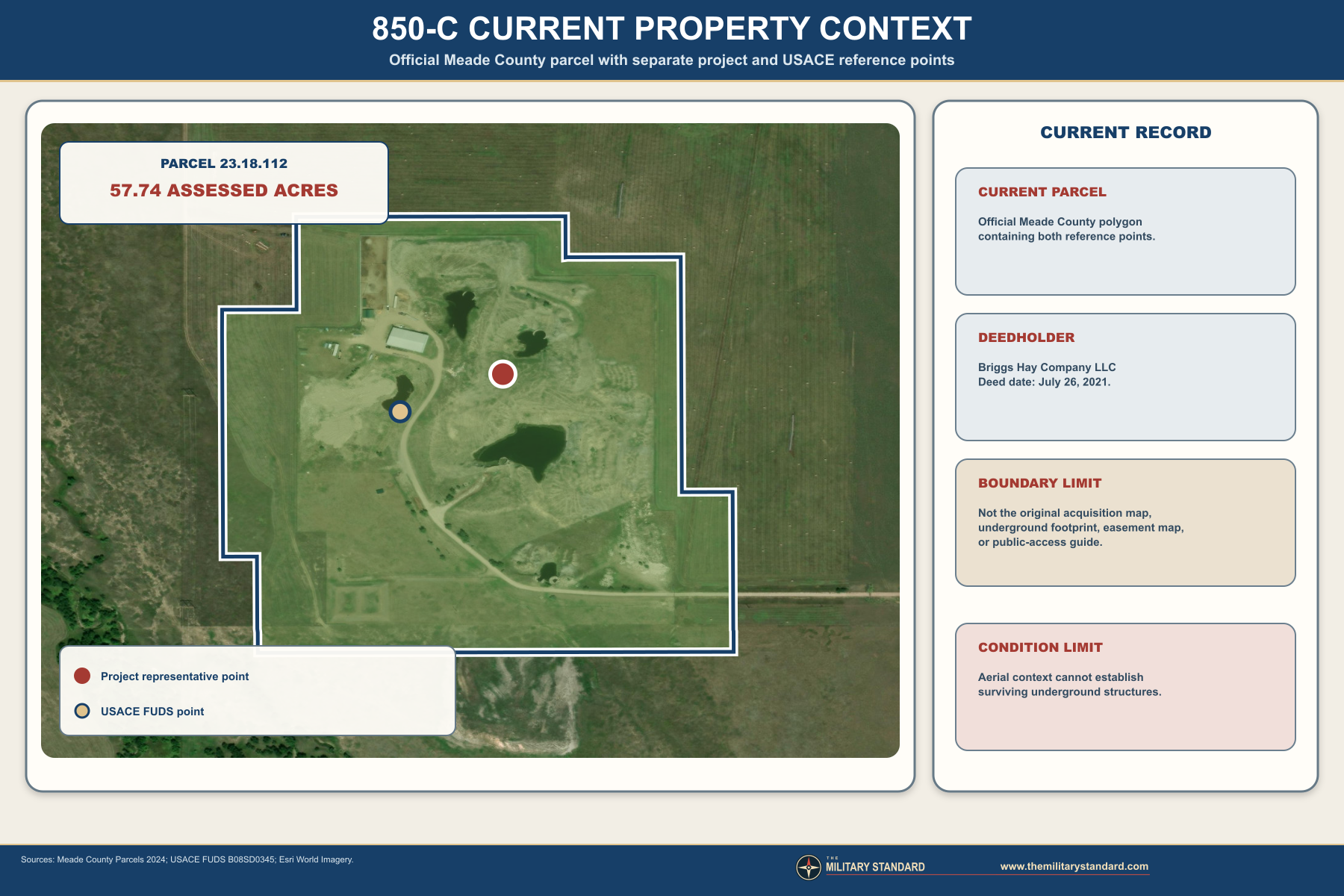

Meade County reports 57.74 acres in its comments field, while the GIS polygon calculates approximately 57.97 graphic acres. A 2019 auction report independently described the offered property as 57 acres. The history uses the county assessed figure for the acreage field and preserves the small mapping difference rather than averaging the values.
The current parcel is not automatically identical to the original military acquisition. The Air Force property could include fee land, access-road interests, communications routes, utility corridors, restrictive easements, and temporary construction areas.
Meade County identifies Briggs Hay Company LLC as deedholder and records a deed date of July 26, 2021, book 934, page 1818. The county class and the Corps current-owner description support agricultural or grazing use. Federal motor-carrier records also associate Briggs Hay Company with the parcel address. These records do not establish the current condition or use of each former missile component.
Titan I was developed alongside Atlas as another path to a reliable operational ICBM. The two-stage missile provided greater range and payload than the earliest Atlas versions, but its operating concept still reflected the limitations of first-generation liquid-fueled systems. The missile remained below ground for protection, was loaded with liquid oxygen during a countdown, and was raised to the surface before launch. That sequence required a very large underground plant and exposed the missile during its final preparation.

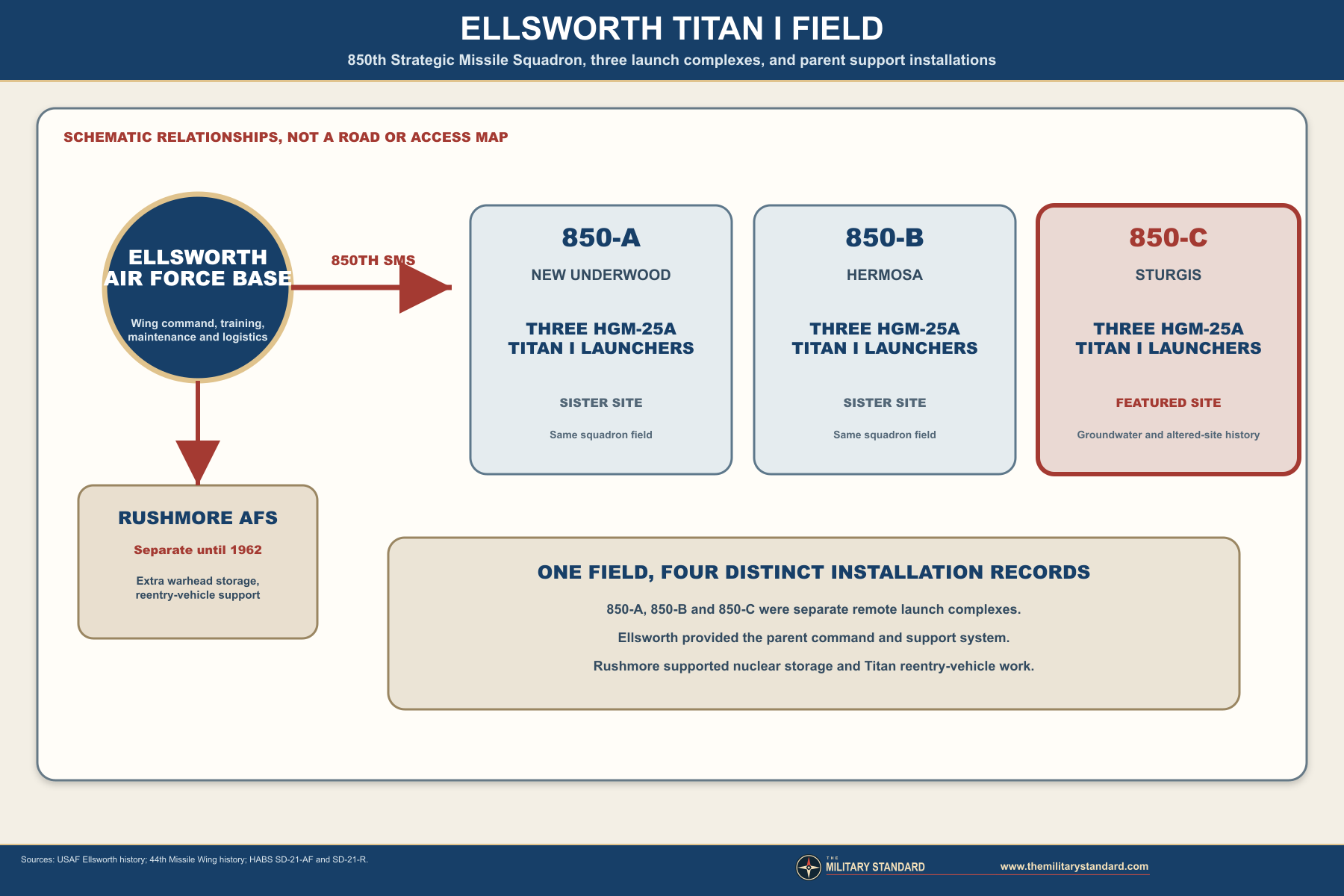

Dispersal reduced the risk that one attack could eliminate the entire squadron. Ellsworth's nine Titans were divided among three widely separated complexes, each with three launchers, its own control center and power plant, and protected guidance equipment. If one complex were disabled, the other two could remain capable of receiving and executing an authenticated order.

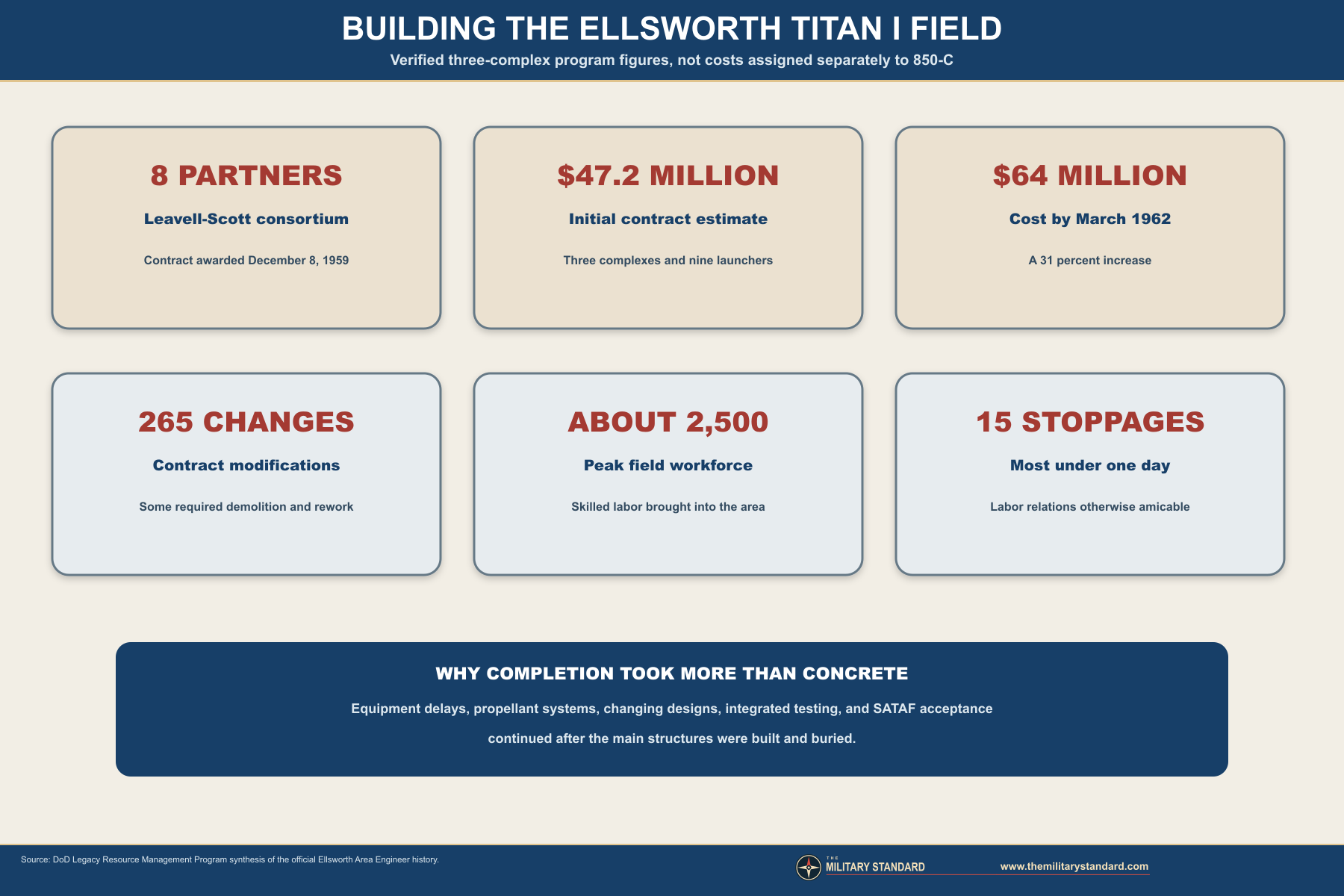

The rural South Dakota setting provided open land and separation, but it also imposed operating costs. Construction materials, specialized workers, missile equipment, liquid oxygen, fuel-system parts, security teams, maintainers, inspectors, food, and ordinary supplies had to reach remote sites over local roads. Reliable power, water, sewage, ventilation, communications, and emergency systems had to be created at each underground complex rather than borrowed from an adjacent base.
The contract began with an estimated value of $47.2 million. By March 1962, it had reached $64 million, a 31 percent increase attributed to 265 modifications. Some changes required contractors to demolish and replace completed work. The figures apply to the Ellsworth field as a whole and cannot be divided evenly among the three complexes, because geology, water, equipment, and corrective work differed by site.
The official synthesis describes a shortage of skilled labor. Workers were brought into the area, turnover was high, and the combined labor force at the three complexes reached about 2,500 at its peak. Labor-management relations were described as amicable. Fifteen work stoppages occurred, most lasting less than a day. A General Electric strike in October 1960 delayed delivery of terminals and affected the completion schedule.
Installing the propellant-loading system proved particularly expensive, as it did at other first-generation missile projects. The history also records a $500,000 groundwater-control problem at Complex 1C. That fact belongs to Site 850-C and is not reassigned to 850-A or 850-B. Its importance here is comparative: even within one standardized field, local conditions could produce major cost differences.
December 1960 can still describe a major phase of visible construction or the chronology remembered by later unit histories. It should not replace the documented 1959 contract award. The record therefore uses a construction period of 1960 through 1962, preceded by the December 1959 award, rather than claiming an unsupported site-specific groundbreaking day.
This reconciliation matters because Titan and Minuteman construction overlapped. By the time Titan equipment was being installed and tested, Peter Kiewit's Minuteman workforce was excavating and building a far larger field. Later institutional memories could easily merge the two efforts.

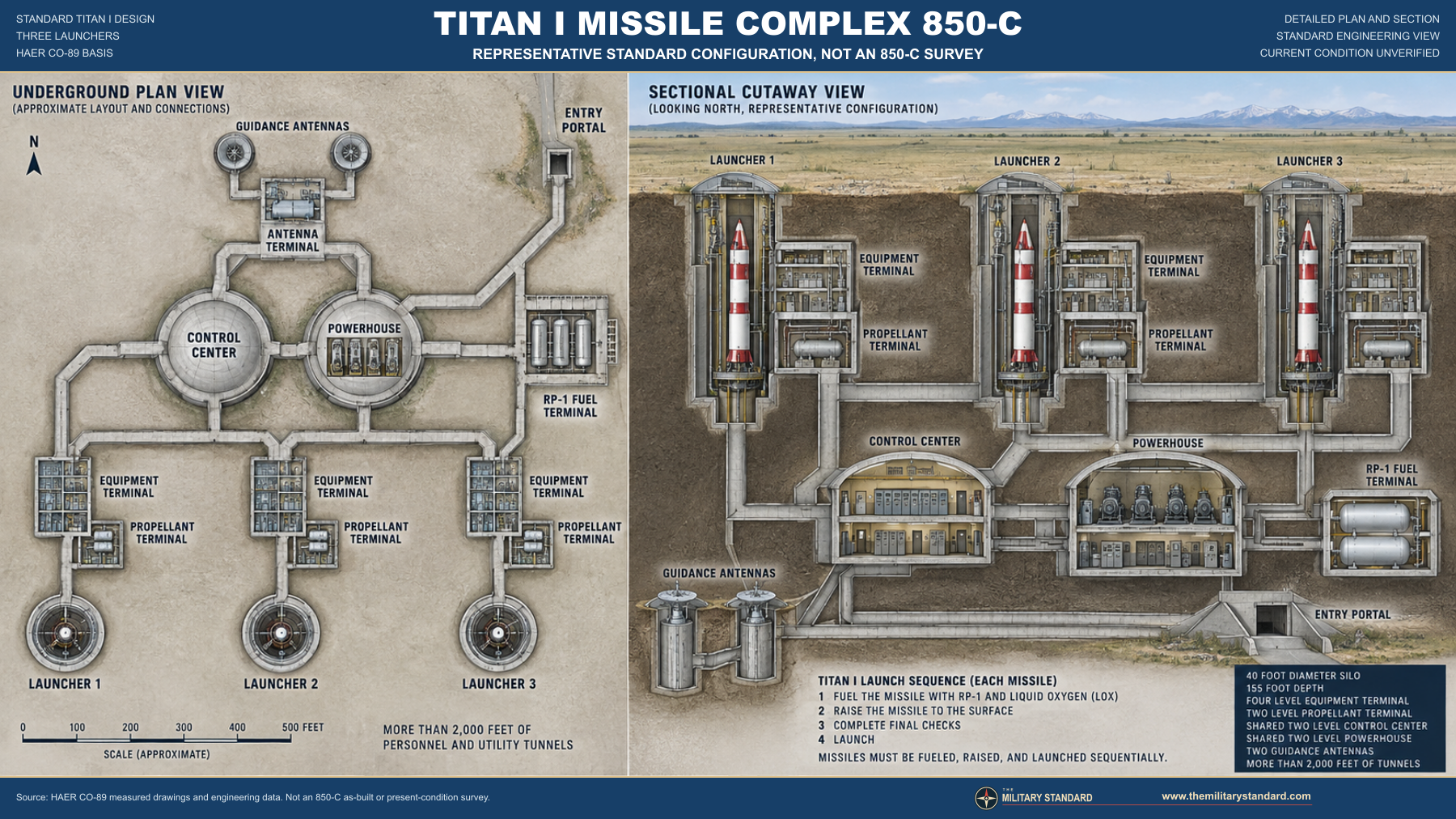

Standard Titan I engineering records describe three launcher silos placed on separate branches around the central plant. Each launcher branch included an equipment terminal and propellant terminal. The central group included the launch control center, powerhouse, entry portal, and two guidance antenna silos. More than 2,500 feet of corrugated-steel tunnel could connect the facilities, generally buried around 40 feet below the surface.
The launch control center contained command consoles, communications, authentication materials, status displays, crew work areas, and environmental systems. The powerhouse contained diesel generators and distribution equipment intended to keep the complex operating if commercial power failed. The entry portal, blast locks, and protected passages controlled access to the deeper plant.
Each missile stood on a large elevator. Titan I could not launch from underground. After receiving a valid order and completing preparation, the crew opened the launcher doors, raised the fueled missile, and launched from the surface. This basic arrangement is firmly documented for the standard system. No 850-C-specific as-built drawing was located, so the history does not claim that every dimension or later field modification exactly matched the representative HAER record.
Communications tied 850-C to its crew positions, squadron command, Ellsworth support organizations, and national command channels. The exact routing and later modifications of every 850-C circuit were not found. Standard system records show that secure voice, order receipt, status reporting, timing, guidance, alarms, and internal communications formed one integrated network. A failure in power, environmental control, a launcher branch, or guidance equipment could affect readiness even if the missile itself was undamaged.
Command and control depended on authentication and two-person safeguards. Missile crews did not select targets independently. They maintained the site, verified status, responded to higher headquarters, and could act only through controlled procedures. The popular image of a single launch button obscures a complex chain of valid-message receipt, authentication, coordinated actions, system permissives, and physical equipment operation.
The propellant terminals housed equipment needed to move and control fuel and oxidizer. Equipment terminals supported elevators, doors, hydraulic machinery, and launcher services. Piping, valves, pumps, sensors, electrical systems, ventilation, alarms, and emergency procedures had to work together. The result was powerful but maintenance intensive.
Crews conducted recurring checks and propellant-loading exercises. These verified tanks, lines, pumps, valves, sensors, timing, communications, doors, elevators, and emergency responses without turning every exercise into an actual launch. The precise exercise schedule at 850-C was not located, so this history describes the standard duty rather than inventing dates.
Titan I's preparation time and exposed launch position were accepted as an interim capability. Titan II could remain fueled and launch from its silo. Minuteman used solid propellant and a smaller, simpler launch facility. Those advances explain why a field that cost $64 million and demanded years of work could be retired after less than three years of operational service.
Workers required badges. People entering below-ground areas signed in and surrendered smoking materials and other flame-producing items, receiving them back when they signed out. The rules reflected both classification and physical hazards. Construction sites contained fuel-system components, electrical work, heavy equipment, open shafts, lifting operations, welding, confined spaces, and newly installed machinery under test.
By February 1962, much of the equipment was installed and being tested. Hydraulic platforms that raised and lowered the missiles required repeated checks. Air Force Security Police assumed increasing responsibility as the sites moved from contractor control toward operational acceptance.
The surviving sources do not provide a complete 850-C worker roster, shift log, injury ledger, or day-by-day construction diary. They do show that the complex was not a single excavation project. It moved through structural construction, equipment installation, correction, integrated testing, security transition, crew training, missile delivery, and final operational readiness.
This distinction separates completion from readiness. A buried concrete plant could look finished while doors, elevators, generators, guidance electronics, communications, propellant systems, alarms, launch consoles, ventilation, or government-furnished equipment still failed tests. Each subsystem had to work alone and as part of an integrated weapon.
The June 22, 1962 milestone indicates that the 44th received nine operational Titan I missiles and had three crews ready for the mission. It does not prove that every individual acceptance document for 850-C was signed on that exact day.
The 850th controlled maintenance and operations for the nine Titan I missiles. Site 850-C held three launchers and a complete crew station. Sister complexes 850-A and 850-B held the other six launchers. Squadron leadership, maintenance organizations, security forces, transportation, supply, training, and parent-base services linked the separated plants into one operational force.
The missile mission existed alongside Ellsworth's bomber work and the enormous Minuteman buildup. The 44th became the first Minuteman IB wing while still responsible for Titan I. Three Minuteman squadrons and 150 new launch facilities made Ellsworth's missile organization much larger, but Titan provided the immediate ICBM alert force during the transition.
Crew preparation required mastery of nuclear command and control, authentication, emergency actions, liquid-oxygen safety, electrical power, hydraulic equipment, doors, elevators, environmental control, communications, and security. Site-specific crew names and rosters were not located in accessible authoritative records. The history therefore keeps personnel discussion at the squadron and documented eyewitness level.
In October 1962, the Cuban Missile Crisis placed Strategic Air Command in an advanced readiness posture. Ellsworth's Titan crews reportedly remained on alert for 72 hours. The source presents this as an Ellsworth field experience and does not identify a particular complex, crew, or launcher. It is therefore included as squadron context rather than claimed as an exclusive 850-C event.
No operational Titan I was launched from 850-C. Deterrence was the mission: a ready force had value because an adversary had to believe that the missiles could survive long enough to retaliate. Daily success meant maintaining the weapon, communications, power, guidance, crew competence, and command procedures without an accidental or unauthorized launch.
The Titan force occupied a narrow historical window. It was operational early enough to matter during the crisis and obsolete soon enough to disappear before many local residents fully understood its scale. Minuteman's dispersed single-silo system soon became the dominant visual and organizational form of Ellsworth's missile mission.
Rushmore Air Force Station formed another important support link. Built just north of the airbase, Rushmore was a separate, highly secure nuclear-weapons storage and maintenance installation. Historic American Buildings Survey documentation says its administration and operation were largely independent and that it maintained its own housing, warehouse, and shop facilities until formal merger with Ellsworth in 1962.
Building 88247 at the former Rushmore station supported Titan I reentry-vehicle maintenance and training from 1962 to 1964. Extra warheads were stored in the weapons storage area while the launch complexes stood off base. This direct Titan relationship means Rushmore deserves a separate preliminary installation record, not merely a passing mention under Ellsworth. The building was documented by HABS and was demolished after 2012.
The South Dakota Air and Space Museum now preserves an Ellsworth-associated Titan I missile. The artifact arrived from California in 1984, remained in storage for decades, received repairs in 2017, and was prepared for display. It is a legacy object rather than proof that a missile from 850-C survived.
The difference in cost was striking. The nine Titan launchers cost about $64 million by March 1962. The 150 Minuteman facilities around Ellsworth cost about $75.7 million. The totals do not include every lifecycle expense and should not be treated as a modern purchasing comparison, but they show the construction advantage of smaller standardized facilities and a mature management system.
Minuteman construction also helps explain source confusion. Peter Kiewit and Sons employed thousands of workers across the South Dakota field while Titan activation continued. By April 1963, the first Minuteman missile was emplaced. By October, the wing controlled a fully operational 150-missile force. Titan remained on alert for a time, but its strategic importance was rapidly overtaken.
Site 850-C did not become a Minuteman launch facility. The systems had different layouts, command arrangements, and property requirements. The former Titan plant entered disposal and reuse, while Minuteman continued at Ellsworth until the early 1990s.
The 850th's missiles were removed from alert on January 4, 1965. This is the best supported date for the end of operational readiness. Deactivation required more than turning off consoles. Warheads and missiles had to be removed, classified materials controlled, propellants and hazardous systems addressed, equipment dispositioned, utilities changed, and the property prepared for federal excess and salvage.
The Air Force inactivated the 850th Strategic Missile Squadron on March 25, 1965. The two dates should remain separate. January 4 marks alert withdrawal; March 25 marks organizational inactivation. The preliminary inventory's February 1 close date is not retained because the reviewed official chronology provides stronger controls.
The complex's military career had lasted less than three years from the June 1962 field readiness milestone. Its brief service was not evidence that it failed to matter. Titan I provided an operational bridge from early ICBM experimentation to a much larger and more durable solid-fueled force.
Salvage at a Titan I site could remove machinery, steel, electrical equipment, wiring, piping, doors, reusable components, and other material with resale value. Removal changed the relationship among structural supports, openings, floors, and barriers. A site described as structurally present in one period could later be excavated, dismantled, flooded, filled, or reworked.
A 2001 Association of Air Force Missileers report called 850-C and 850-B reasonably good in condition after a permitted visit. A separate enthusiast photographic record says pumping and destructive excavation occurred before February 2013 and presents images of dismantled powerhouse, equipment-terminal, control-center, and silo structures. This evidence is valuable for sequence and appearance but is not an official demolition permit or engineering completion record.
The 2019 KOTA auction report provides an independent later checkpoint. It described three existing silos filled with water, a steel building, farm equipment, and substantial work already completed. The article's simultaneous reference to existing silos and silos that had been brought down demonstrates why the present history does not say that every underground component was removed. Major destruction is documented; total obliteration is not.
The property sold at auction for $119,000 in October 2019. Meade County's current layer records a later July 26, 2021 deed to Briggs Hay Company LLC. The reviewed sources do not prove whether the auction buyer and later deedholder were the same legal party or whether an additional transfer occurred. The chronology preserves both records without forcing an unsupported connection.
The published South Dakota FUDS inventory lists two records for the property, including hazardous, toxic, or radioactive waste and containerized hazardous, toxic, or radioactive waste categories. A Department of Defense final-response table lists two Installation Restoration Program sites, no Military Munitions Response Program sites, and $177,000 in costs through fiscal year 2023.
Those program labels prove that environmental work was tracked and reached the reported response milestone. They do not identify every contaminant, sample result, removal volume, institutional control, demolition effect, or present subsurface condition. They also do not show that every structural hazard created by military use, salvage, flooding, pumping, or later excavation was evaluated through FUDS.
Project closeout and final response complete are environmental-program statuses. This status is not a warranty that a former underground missile facility is structurally safe. FUDS does not establish public access, certify the stability of excavated or filled areas, or replace current property controls and confined-space restrictions.
The reviewed public sources did not provide the complete site-specific decision document or sampling appendix for B08SD0345. The history reports verified program categories and status without inventing contaminants. Fuel-system residues, industrial fluids, electrical materials, demolition debris, standing water, and disturbed soils are plausible concern classes, but plausibility is not substituted for analytical evidence.

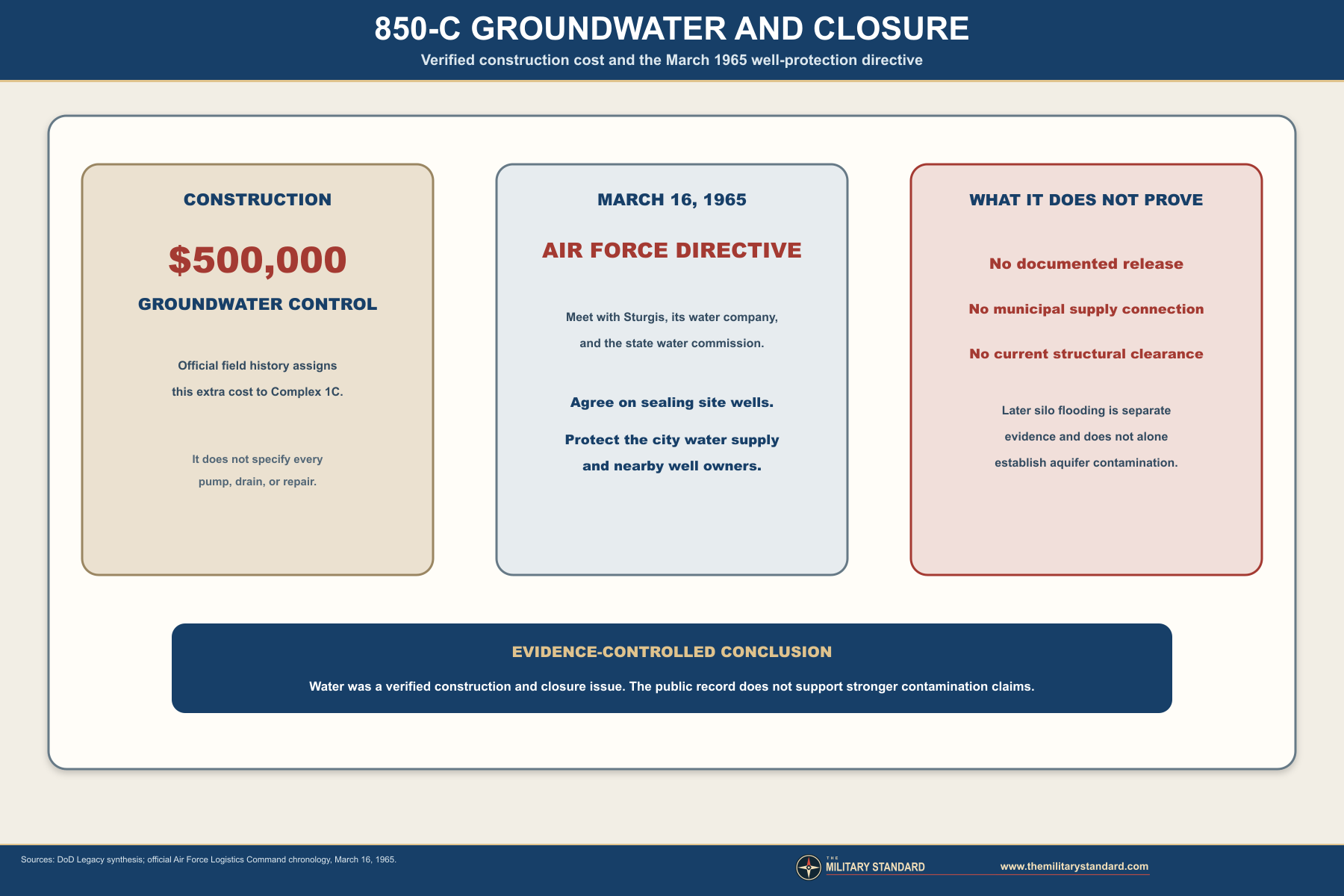

On March 16, 1965, the Air Force Directorate of Civil Engineering directed the responsible phaseout command to arrange a meeting with Sturgis officials, the Sturgis Water Works Company, and the South Dakota Water Resources Commission. The purpose was to agree on sealing wells at the Titan I Complex C and to protect the Sturgis water supply and other well owners in the area.
That direction shows regulatory and public-water concern during closure. It does not state that a release occurred, that the complex supplied city water, or that municipal wells were contaminated. The correct historical interpretation is narrower: site-well closure had to be coordinated so that it would not harm regional groundwater users.
Later reports of flooded silos and prolonged pumping fit the site's known groundwater sensitivity, but they remain separate evidence. Flooding inside a deep underground plant does not by itself prove contamination of an aquifer or municipal supply. Likewise, environmental response complete does not establish that underground rooms are dry or structurally usable.
These public records support agricultural and commercial context. They do not establish that the parcel is used continuously for grazing, that a carrier operation occupies every portion, or that any former missile room is in service. The official county parcel record controls the ownership statement; the federal carrier record only confirms a current business connection to the address.
The 2019 auction report said potential uses included grazing, a homesite, or a Sturgis Rally campground, but those were suggestions at the sale, not verified later land uses. No approved museum, campground, public tour, or adaptive-reuse program was located.
Private ownership does not create public access. The address, parcel polygon, and coordinates are supplied to identify the historic property and reconcile records. They do not authorize entry or identify safe areas.
The current parcel geometry preserves the outline of the private property, not the underground installation. Recent aerial imagery shows disturbed areas and modern agricultural or commercial activity, but imagery cannot establish whether tunnels, lower silo sections, the control center, powerhouse, guidance antenna foundations, or buried debris remain.
No current professional structural inspection, interior survey, demolition completion report, or as-built record of the postmilitary excavation was located. The correct status is therefore major destructive alteration with residual underground condition unverified. Calling the complex intact would be obsolete; calling it entirely gone would exceed the available evidence.
Water-filled or altered shafts, buried voids, uncompacted fill, demolition debris, unstable edges, and confined spaces can remain hazardous. The absence of a visible Cold War structure on the surface is not proof that subsurface hazards have disappeared.
Former missile complexes can contain deep shafts, unstable fill, deteriorated concrete, standing water, oxygen-deficient spaces, electrical remnants, sharp salvage edges, animals, and contaminated media. Major demolition can create additional hazards by removing supports, exposing debris, and concealing voids.
The South Dakota Air and Space Museum provides a lawful way to encounter Ellsworth's Titan legacy through a preserved missile artifact. Historic American Engineering Record documents and official Air Force photographs provide safe access to the engineering story. These alternatives are preferable to unauthorized entry.
The property graphic uses the official Meade County parcel polygon, project point, and USACE FUDS point over current aerial context. It does not mark gates, wells, surviving voids, underground components, or safe routes. The current 57.74-acre parcel is distinguished from the unknown original military acquisition.
The groundwater graphic separates verified construction cost and the March 1965 Air Force well-protection directive from later flooding reports. The transformation timeline distinguishes official milestones, dated observations, secondary demolition documentation, the 2019 auction, and the 2021 deed record.
