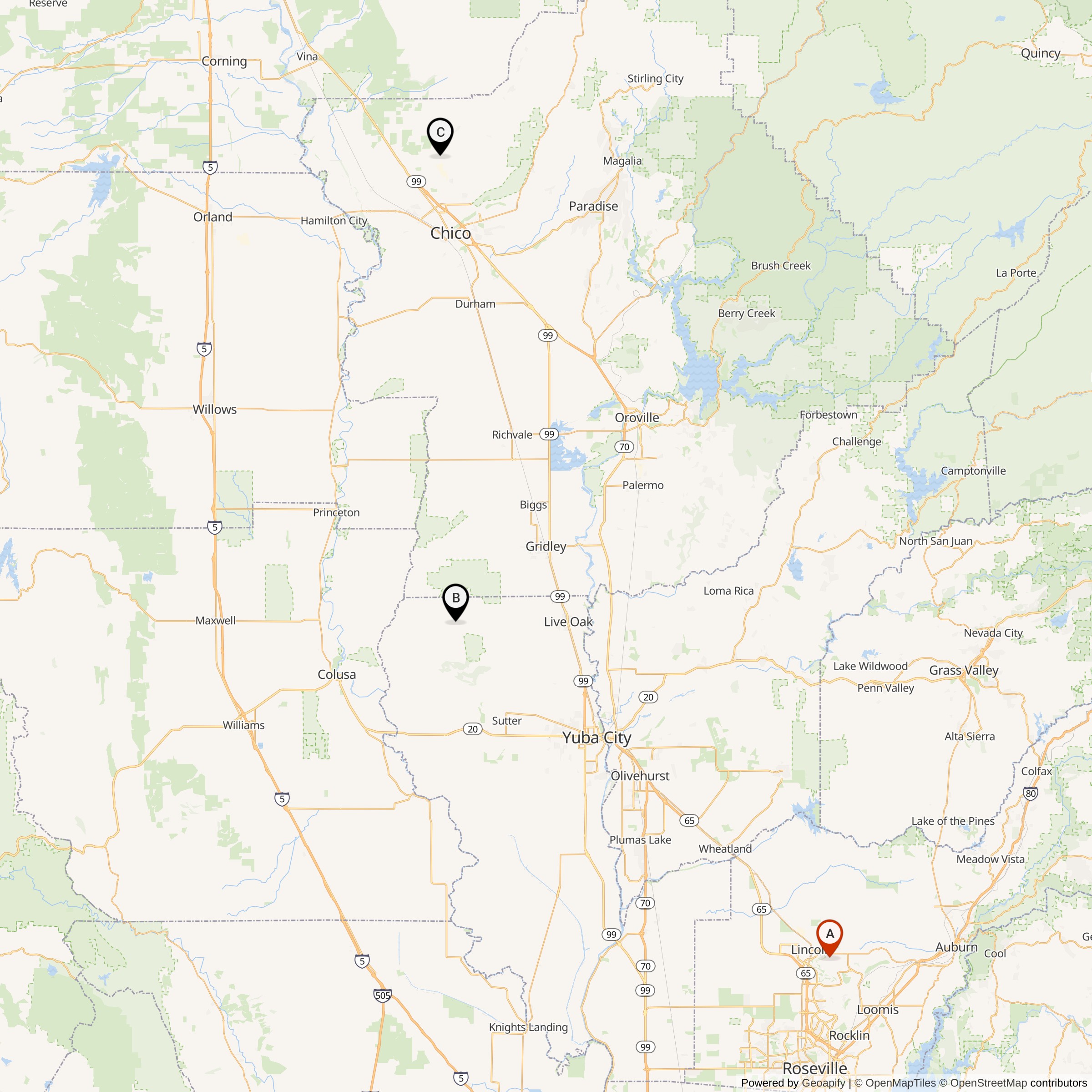

Titan I 851-A
Squadron: 851st SMS
Date Activated: February 1st 1961
Date Deactivated: March 25th 1965
Air Force Base: Beale
State: California
Nearest Town: Lincoln
Coordinates:
Latitude: 38°52'54.90"N
Longitude: 121°15'56.62"W
Decimal:
3 silos

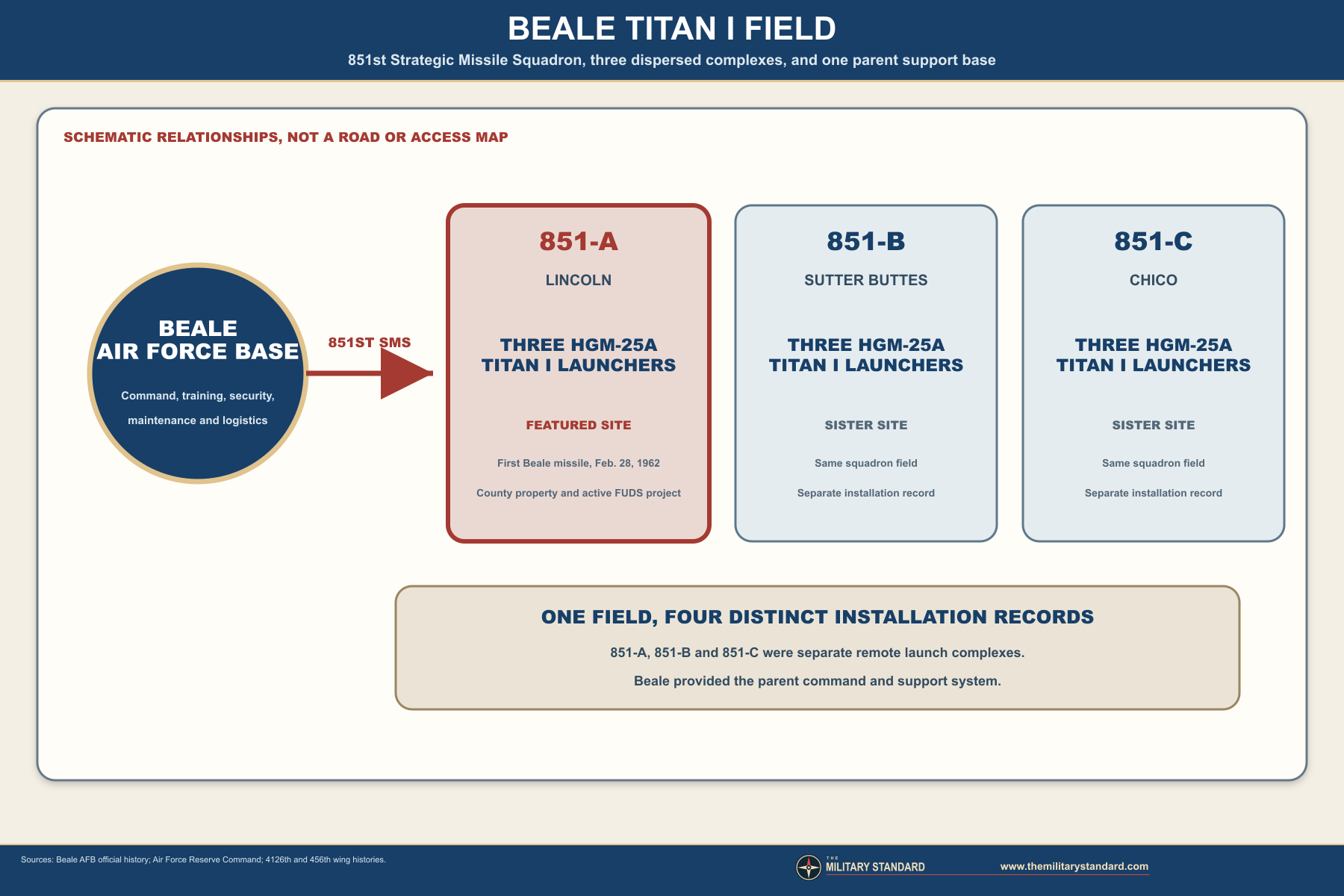

Former Titan I Missile Complex with the 851st Strategic Missile Squadron
Read about the Titan I at Beale AFB
List of all Titan I site Coordinates
Detailed information about the Titan I Intercontinental Ballistic Missile can be found here.
The Lincoln complex is especially well documented because it became a county property and later a major federal environmental-restoration project. Official records identify a roughly 46-acre fee parcel surrounded by a much larger envelope of safety, access, and other easements. They also preserve unusual construction detail, including hard granite, shallow groundwater, about 470,000 cubic yards of excavation, an on-site concrete batch plant, and approximately 90,000 cubic yards of concrete attributed to this facility. Those figures describe a civil-engineering undertaking as much as a weapons installation.

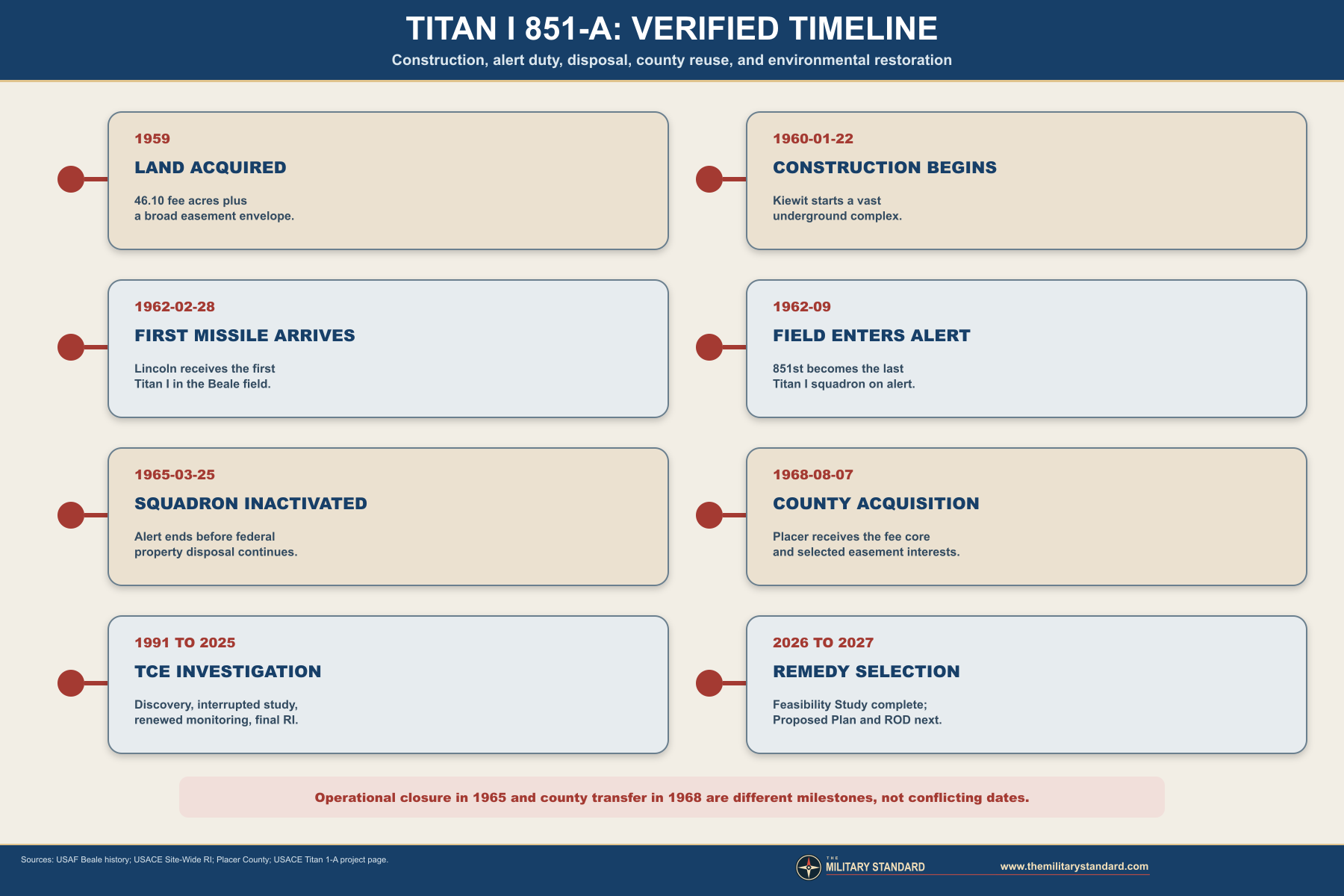

The operational era was brief. The first missile reached the Lincoln complex on February 28, 1962, the Beale field achieved alert status in September, and Titan I phaseout began little more than two years later. The first Beale Titan left alert on January 4, 1965, and the 851st was inactivated on March 25. By June 1965 the federal government was transferring the fee land and easement interests into the disposal process, and by 1968 Placer County had acquired the core property.
Postmilitary reuse produced a second, complicated history. County functions included a corporation yard, California forestry and fire facilities, road-maintenance activity, and pistol and trap or skeet ranges. Trichloroethene, usually abbreviated TCE, was identified in groundwater during environmental investigation, while lead contamination came from the later county ranges. The U.S. Army Corps of Engineers is responsible for the FUDS groundwater and soil-vapor response; Placer County is separately responsible for the gun-range lead cleanup. Keeping those two programs distinct is essential to an accurate present-day account.
Several official names refer to this same place. Air Force historical writing uses 851-A and Complex 4A, while Corps documents use Former Beale AFB Titan 1-A Missile Facility, Beale AFB Facility S-1, property number J09CA1108, property identifier CA99799F599600, and HTRW project J09CA1108-01. County records often shorten the name to the former Titan 1-A missile site or Lincoln former missile facility.
The letter and number systems can be confusing. The squadron designation was 851st, the field's western site was A, and contemporary Air Force narrative calls it Complex 4A. Modern FUDS usage says Titan 1-A, in which the numeral identifies the missile system and the letter identifies the Lincoln complex. This history preserves the established public-page name 851-A while listing all authoritative aliases so that records can be matched without inventing a new identity.

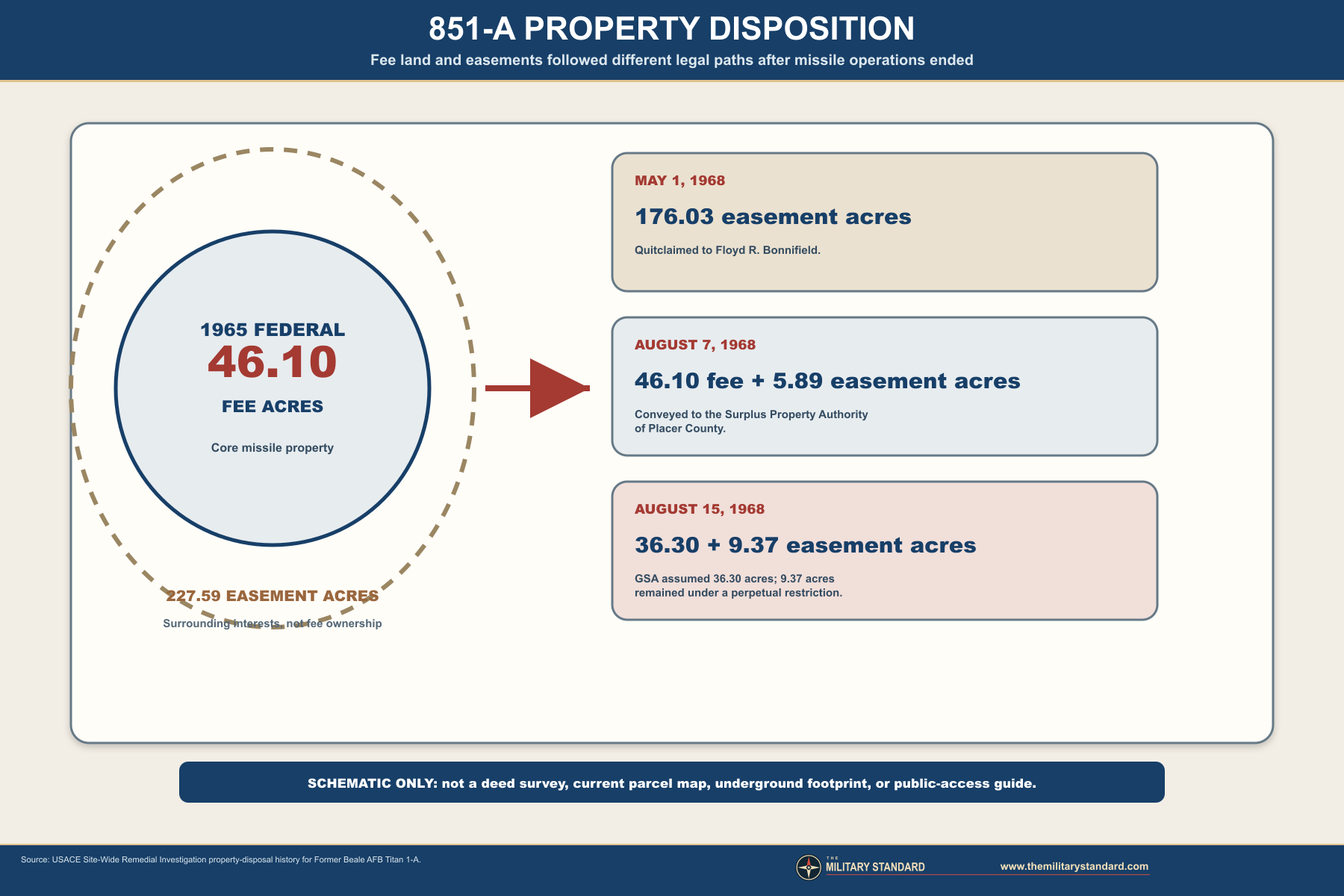

The official disposal schedule separates fee ownership from easements. The United States reported 46.10 fee acres and 227.59 easement acres sent to the General Services Administration on June 22, 1965, while another 1.30 acres of easements were terminated. The combined fee and transferred-easement figure is 273.69 acres, close to the approximately 275 acres often used in Corps summaries. It would be misleading to enter 275 acres as if the government owned every acre in fee or as if the missile plant physically occupied that entire envelope.
The approximately 46-acre core also should not be confused with the underground footprint. The three launcher areas, control center, power house, antenna silos, terminals, tunnels, access portal, and surface support occupied only portions of the fee property. The easement belt served isolation, safety, access, utilities, and restrictions beyond the structural core. Later county parcel divisions created park, mixed-use, and corporation-yard parcels without changing the historical fact that the original military interests were broader and legally varied.
Beale offered strategic and geographic advantages. Its inland California location supported dispersed sites away from the coast, while the Sacramento Valley provided access to transportation, construction labor, utilities, and a major Air Force support base. The three complexes were separated from Beale and from one another, reducing the chance that one attack or one accident would disable the entire field. Beale supplied the institutional center for personnel, training, logistics, nuclear support, administration, maintenance, and communications while the remote complexes performed the alert mission.
The missile assignment also fit Beale's transformation. The former wartime Army installation was becoming a Strategic Air Command base with expanding bombardment, tanker, missile, and later reconnaissance responsibilities. Official Beale history places the Titan support era between 1959 and 1965. The 851st was assigned first under the 4126th Strategic Wing, which SAC had activated at Beale, and then under the 456th Strategic Aerospace Wing after the 4126th was redesignated on February 1, 1963.
The fee-and-easement pattern shows how Titan deployment shaped land control. The Air Force needed direct ownership of the structural core but could protect the complex through easements across a much larger surrounding area. These interests could limit incompatible development, provide access, or support utilities without requiring federal purchase of every surrounding parcel. The pattern also explains why disposal took several transactions: fee land could be conveyed to a public agency, some easements could revert to prior owners, and restrictive interests could remain or be assumed separately.
Site choice proved technically demanding. Corps accounts describe hard, shallow granite and groundwater encountered only 20 to 30 feet below ground. Those conditions increased drilling, blasting, pumping, and mud-control work. The Lincoln site was therefore not merely a standard plan placed into an empty field. Local geology dictated the actual pace, methods, temporary works, and risk of construction, and it helps explain the extraordinary excavation and concrete quantities recorded in the site history.
The management change reflected the exceptional demands of first-generation ICBM construction. A Titan complex combined heavy underground civil works with precision missile equipment, cryogenic propellant systems, high-capacity electrical generation, protected communications, and exacting installation tolerances. The builder could not treat the site as a conventional industrial project, because structural completion had to connect with weapons-system installation, acceptance testing, crew training, and Strategic Air Command operational certification. Schedule pressure was intense while design changes and field discoveries continued.

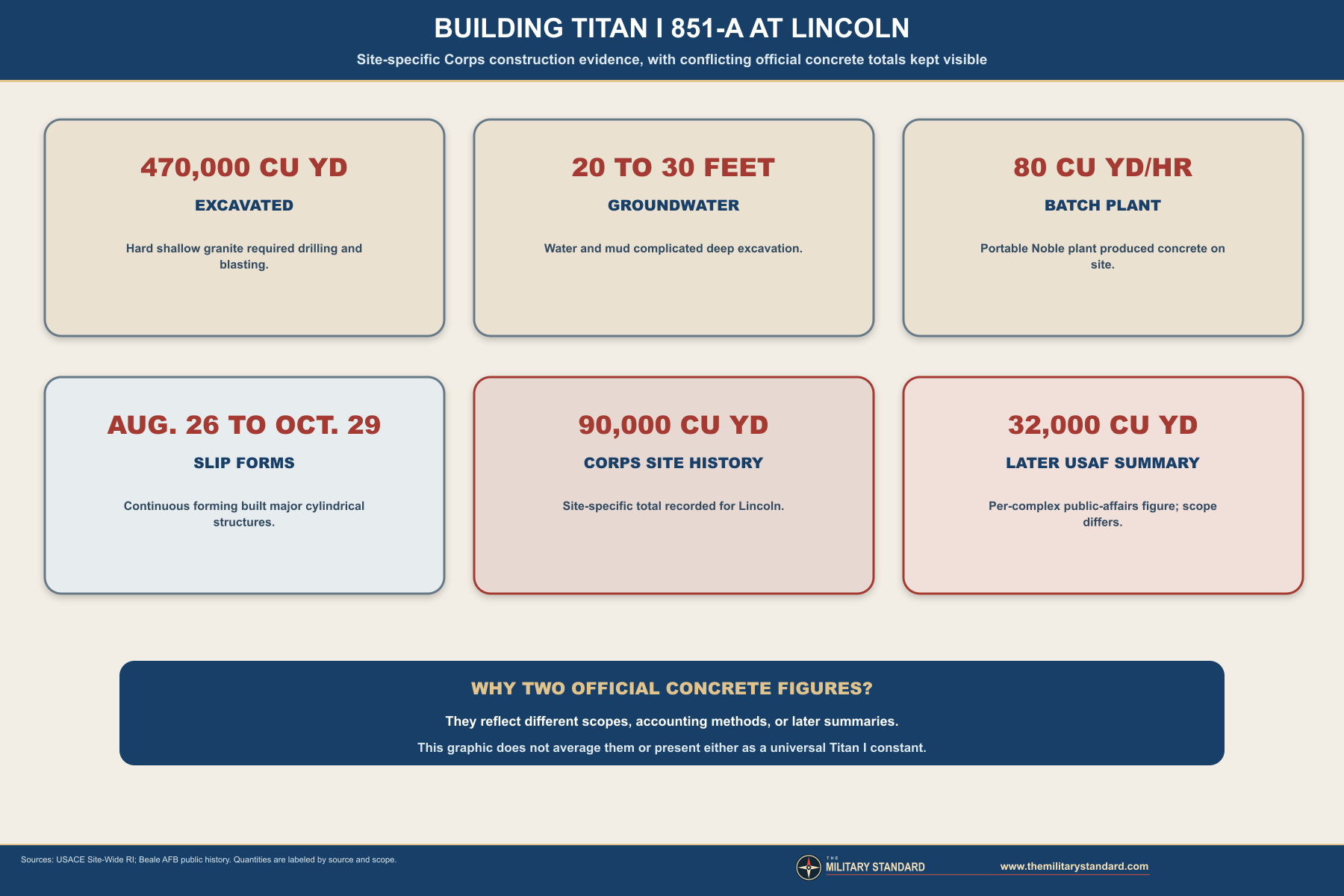

Parish Brothers of Benicia performed excavation work, and open-cut excavation was reported complete on June 27, 1960. Silo shafting had begun on March 10.
Backfilling began in September 1960 as major concrete structures rose within the excavations. The sequence was deliberate: builders excavated a huge open complex, constructed reinforced cylinders and rooms, installed or protected embedded systems, and then returned material around the hardened plant. The completed installation concealed much of the work below a comparatively sparse surface. That contrast between modest surface appearance and massive underground volume is one of the defining characteristics of Titan I sites.
The groundwater encountered during construction foreshadowed later environmental and structural concerns, but it should not be equated automatically with contamination. Natural groundwater entered the deep excavations because the facility extended far below the water table. Decades later, environmental investigations addressed TCE in groundwater and soil vapor, while the submerged or flooded underground plant presented separate access and engineering hazards. The existence of water in the silos does not by itself identify the source or concentration of a chemical release.
The Lincoln work used a portable Noble concrete batch plant rated at roughly 80 cubic yards per hour. Aggregates came from the Richter and Harm Bear River plant near Sheridan. Slip-form operations extended from August 26 through October 29, 1960, allowing crews to construct tall cylindrical reinforced-concrete features with continuously moving forms. The specialized forms fabricated for Lincoln were then used at the Beale field's B and C complexes, giving 851-A an important role in the construction sequence beyond its own boundary.
The form reuse also helps explain why field construction was a networked program. Lessons, tooling, crews, and production methods moved from one complex to the next. A problem solved at Lincoln could benefit Sutter Buttes and Chico, while design changes at a later site could affect acceptance or retrofit work across the field. The three installations shared a weapons mission, but the sequence of construction created practical dependencies among them before any missile went on alert.
Each launcher branch functioned as part of one integrated plant rather than as an independent hole in the ground. Electrical power, communications, environmental control, propellant service, guidance data, and command authority had to reach the launcher through protected spaces. The control center supported combat-crew operations and authentication. The power house maintained electrical continuity. Antenna equipment connected the site to the external guidance and command network, while the terminals managed the hazardous fluids required to ready a missile for launch.

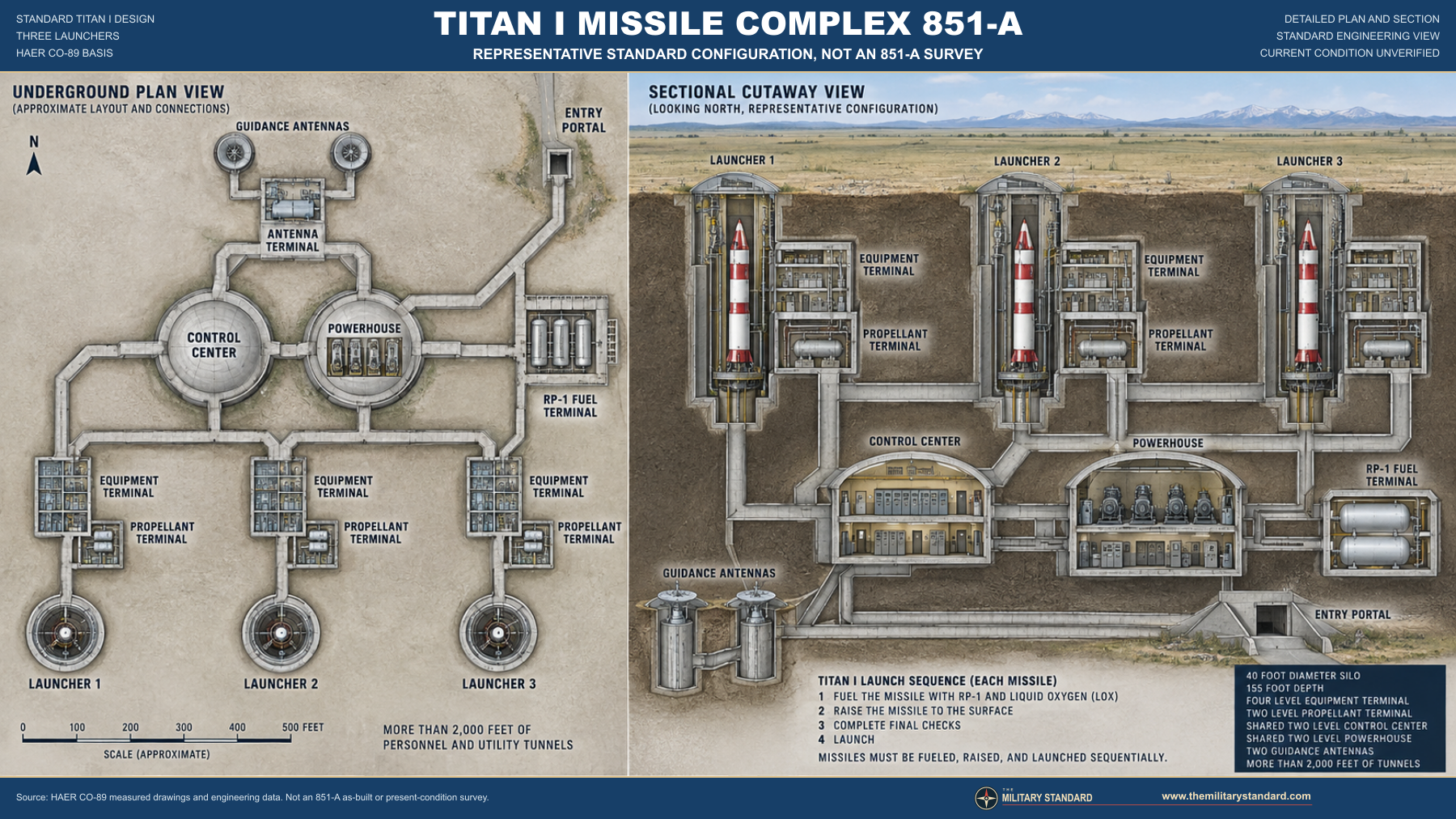

The surface plan was intentionally understated. Roads, vents, portals, covers, support buildings, fencing, security zones, and utility features marked the site, but most operational volume lay below ground. The silos protected missiles during alert storage; they were not launch tubes in the later Minuteman sense. Before launch, Titan I had to be fueled, raised to the surface by elevator, and launched from the exposed position. That sequence imposed time, machinery, and vulnerability penalties that later solid-fueled missiles avoided.
The standard-layout graphic accompanying this history is therefore labeled as a verified standard engineering interpretation, not a surveyed Lincoln as-built plan. It shows functional relationships supported by Titan I engineering documentation without pretending to reproduce every local road, grade, fence, or postmilitary alteration. The current aerial photograph is kept separate so viewers can distinguish the Cold War system diagram from what remains visible today.
An alert sequence required verified command messages, crew coordination, system checkout, propellant operations, guidance readiness, opening the silo cover, raising the fueled missile, and completing launch from the surface. The crew did not simply press a button beside a permanently fueled missile. Multiple mechanical, electrical, communications, and procedural systems had to work in order. The elaborate complex was a physical expression of that chain, and the short service life reflected how rapidly the Air Force improved beyond it.
The Titan I carried a nuclear reentry vehicle and served a deterrent mission rather than a routine firing program. No missile was launched from the Lincoln facility. Operational success was measured by secure alert time, readiness inspections, crew proficiency, maintenance, and the ability to execute a valid order if national command authority required it. The absence of a launch is not evidence that the installation was inactive; continuous alert without use was the purpose of the deterrent.
The squadron's mission required much more than launch crews. Missile maintenance specialists, facilities personnel, communications technicians, security forces, supply functions, trainers, evaluators, and headquarters staff linked the remote sites to Beale. Each complex had to sustain crews underground, maintain the missile and its support equipment, control access, and communicate through protected channels. Beale handled many functions that did not need to be duplicated at every launcher location, while the sites maintained the equipment and personnel that had to remain close to the weapons.
The squadron belonged to Strategic Air Command's larger missile structure. It was assigned to the 4126th Strategic Wing from organization in 1961 until February 1, 1963, when the 456th Strategic Aerospace Wing replaced the 4126th and assumed its mission, personnel, and equipment. That relationship placed the dispersed field inside a base organization already responsible for strategic missions. The installation history therefore cannot be understood by looking only at the 46-acre Lincoln parcel; it was one node in a wider chain of command, logistics, nuclear custody, training, and communications.
The Lincoln emplacement also marked a transition from construction project to weapons installation. Responsibility shifted gradually among contractors, Corps engineers, Air Force acceptance teams, maintenance personnel, and operational crews. Deficiencies could require correction after structural work appeared complete. The site's readiness depended on both the physical plant and the Titan weapon system, so published dates for completion, turnover, control, and alert describe different phases rather than interchangeable versions of a single opening day.
Two months after the entire squadron became fully operational, it became the first Titan I unit to pass an Operational Readiness Inspection. That achievement reflected crew performance, maintenance, security, communications, technical orders, and the reliability of the full support system. It did not erase the difficulties of first-generation missile technology, but it shows that the Beale field developed into a credible operational force after the compressed construction and activation period.
The timing placed the new field inside one of the most dangerous periods of the Cold War. The Cuban Missile Crisis unfolded in October 1962, shortly after the squadron reached alert. The Lincoln complex was therefore not a completed facility waiting for some future mission; it was part of the national strategic force during an immediate confrontation. Exact crew actions at 851-A during the crisis were not located.
The Chico accident mattered to Lincoln even though it occurred at another complex. A serious event at one site affected the squadron's total launcher count, technical procedures, safety awareness, investigation workload, and public understanding of the field. It also illustrates the reason for geographic dispersal: damage at one complex did not physically destroy all nine launchers. At the same time, common equipment and procedures meant that findings could have implications beyond the damaged site.
Construction tied the field together in a different way. Forms produced at Lincoln were reused at the other complexes, and program management applied across all three. Beale public affairs later summarized the total cost of the three sites as more than $40 million. Because the sites shared contracts, support systems, and standardized engineering, some surviving totals are field-wide rather than cleanly divisible among A, B, and C. Site-specific and program-level figures are labeled accordingly throughout this history.
The complex also depended on civilian infrastructure and regional geography. Roads carried oversized construction loads and later missile and support equipment. Commercial suppliers furnished aggregate, concrete inputs, cable, piping, and thousands of components. Local property interests carried easements and restrictions. After closure, the same site entered county road, fire, recreation, and land-planning systems, showing how a secretive strategic facility could become deeply entangled with ordinary regional government.
The first Beale Titan was removed from alert on January 4, 1965. Public sources do not identify that missile conclusively as a particular Lincoln launcher, so this history treats January 4 as a field milestone rather than claiming an unsupported silo-level event. The 851st Strategic Missile Squadron was inactivated March 25, 1965. Those dates distinguish alert termination from unit inactivation, and neither should be confused with later property disposal or the date on which every missile component had physically left the complex.
The missiles were removed by March 1965, dismantled, and shipped to the San Bernardino Air Materiel Area at Norton Air Force Base. Salvage and system removal stripped the facility of military equipment with reuse or material value. Later launcher-disablement actions are sometimes described in relation to Strategic Arms Limitation requirements, but SALT I came years after the immediate 1965 retirement. The original phaseout resulted from weapons modernization; later treaty-verification or disablement practices belong to a separate chronology.
On August 15, 1968, GSA assumed 36.30 acres of easements, while 9.37 acres remained under a perpetual restrictive easement according to the property account. The reviewed sources do not provide a modern title opinion tracing every one of those interests to the present. They do establish that federal disposal was a staged legal process and that Placer County became owner of the core former missile property in 1968.
The disposal chronology also resolves an apparent date conflict in municipal summaries that call the site decommissioned in 1968. Military alert and squadron operations ended in 1965; federal property disposition and county acquisition continued through 1968. Both dates are meaningful, but they answer different questions.
The county closed the gun ranges in 1999. By 2016 it described the property as a 46-acre site and continued to use part as a corporation yard. A recorded parcel map divided the property into park, mixed-use, and corporation-yard parcels while preserving the exterior boundary. Later agreements conveyed road right-of-way and related easements to the City of Lincoln for new roads, utilities, and landscaping connected with Village 1 development around the site.
Lincoln's growth transformed the setting. Land that had been selected for rural isolation now lies next to expanding residential development, including Sun City Lincoln Hills. This change did not move the historical installation, but it increased the importance of precise environmental communication, wildfire and field-work controls, property planning, and public participation. It also means that historic photographs showing open countryside cannot be used as a current land-use map.
Investigators sampled flooded underground structures in 1993 and conducted additional work in the mid-1990s. A later pilot treatment in the 2000s removed about ten pounds of TCE. Field work stopped in 2009 for more than a decade while the government examined causation and eligibility under the FUDS program, then investigative work resumed in 2018 with additional monitoring wells and soil-vapor probes. This interrupted chronology helps explain why a contamination first identified decades ago remained in the investigation and remedy-selection process in 2026.
TCE occurrence and the deep underground plant are related but not identical subjects. Water in a silo may provide a sampling medium or pathway, while contamination in groundwater and soil gas is evaluated through monitoring networks, geology, concentration trends, exposure assumptions, and regulatory standards. A photograph of a flooded opening cannot define the plume. Conversely, an environmental program status does not certify the stability of old underground structures.
The modern monitoring network included 33 groundwater wells and 24 soil-vapor probes. Additional wells and probes were installed to improve definition of the western or northern edges and to investigate soil-vapor findings. The final Remedial Investigation, released in February 2025, concluded that the extent of contamination above drinking-water standards was largely understood and that groundwater and soil vapor could create unacceptable future risk if left unaddressed. That future-risk conclusion is compatible with the current statement that nearby residents face no imminent risk.
USACE says groundwater at the project location is not used as a drinking-water source. It also reports that current monitoring data do not indicate an imminent risk to neighboring communities. Those statements do not mean that no cleanup is necessary, because remedy selection considers future land and water use, vapor pathways, plume behavior, and long-term protectiveness. Accurate public history must preserve both parts: no imminent current community risk and a documented contaminant problem requiring continued federal action.
The Corps schedules a Proposed Plan and Record of Decision for 2027. The Proposed Plan will identify a preferred alternative and open a public-comment period. The Record of Decision will document the selected remedy and respond to comments, after which remedial design and remedial action can proceed. These are planned dates, not completed milestones, and they should not be rewritten as guarantees that cleanup construction will start or finish in a particular year.
Treatability work evaluates whether in-situ chemical oxidation and enhanced bioremediation can reduce contamination under actual site conditions. Monitoring rounds were scheduled for the weeks of May 11 and September 7, 2026, with a draft treatability report due to the regulator in March 2027. Separate semiannual groundwater monitoring was being contracted for late 2026. These activities show that remedy development remained technically active after completion of the main investigation and feasibility reports.
As of September 2026, the next listed meeting was October 15, 2026. The Corps selected a new community co-chair in April 2026 and continued newsletters, presentations, meeting records, and technical updates. Public concern has focused on plume direction, nearby development, health, property values, monitoring coverage, project pace, and site hazards. The record benefits from this engagement because it produces dated explanations that can be checked against technical reports rather than leaving the history dependent on rumor.
By July 2026, county work had recovered and recycled more than 12 tons of lead material, sent more than 400 truckloads of soil to hazardous-waste facilities, and completed about 85 percent of the original base-bid scope, including full removal of the pistol-range berm. The Board of Supervisors approved an updated contract that brought the project total to about $8.6 million. Work was scheduled to continue during summer and early fall.
County material says the property could eventually support a park or another use, but such possibilities are not a completed reuse decision. Environmental cleanup, land planning, road construction, and the continuing corporation yard affect what can happen next. This history therefore records the verified present use and active cleanup while labeling possible future park use as planning context rather than a current status.
Deep flooded structures, confined spaces, deteriorated concrete and steel, buried voids, environmental monitoring equipment, excavation areas, and work traffic can create serious hazards. County ownership and public-agency activity do not make the former launch plant an open park. Coordinates and historical diagrams are supplied for identification and interpretation only. They are not instructions for entering the property, locating openings, or bypassing controls.
The available public record does not provide a current professional structural survey of every underground component. Statements such as intact, demolished, or filled can therefore be misleading unless attached to a particular feature and date. The defensible conclusion is that major Titan I structures remain as subsurface or surface remnants, the exact condition varies and is not fully documented publicly, and both environmental and redevelopment work continue to change parts of the site.
The final Remedial Investigation and Feasibility Study are complete, but remedy selection is not. USACE schedules the Proposed Plan and Record of Decision for 2027 and continues treatability and groundwater-monitoring work. Current data indicate no imminent risk to nearby residents, and project-location groundwater is not used for drinking. Those reassuring current findings coexist with the need to address potential future groundwater and vapor risks.
The property is also part of a rapidly changing urban edge. New roads, easements, nearby subdivisions, and possible future park or mixed-use decisions place the former military site within Lincoln's long-range development context. Its historical importance, environmental obligations, county operations, and physical hazards all remain relevant to any future reuse.
